Fulfillment Centre Bottleneck Analysis
A fulfillment centre tests express prioritisation, machine maintenance windows, and throughput limits using constraint-based scheduling to find what really drives delays.
Setup
A fulfillment centre handles 10 job orders/day across 9 machines (Receiving, Storage, Picking, Packing, Shipping, Express Pick, Palletize, Inspection, Kitting). Six order types follow different routes through the facility:
| Order Type | Route | Theo Duration | Deadline |
|---|---|---|---|
| Standard B2C (×3) | Rec→Store→Pick→Pack→Ship | 16h | 24–32h |
| Express (×2) | Rec→ExpPick→Pack→Ship | 11h | 14–16h |
| B2B Pallet (×2) | Rec→Store→Palletize→Ship | 15h | 27–31h |
| Kitting (×1) | Rec→Store→2×Pick→Kit→Pack→Ship | 21h | 31h |
| Returns (×1) | Rec→Inspect→Store→Pick→Pack→Ship | 22h | 34h |
| Heavy Pallet (×1) | Rec→Store→Pick→Pack→Palletize→Ship | 29h | 42h |
50 operations total, each pinned to a specific machine with fixed durations and precedence constraints. Picking (38h load) and Packing (34h) are the main bottlenecks. Express Pick (6h), Inspection (6h), and Kitting (5h) are lightly loaded.
We build the schedule as a constraint optimization problem using MiniZinc + OR-Tools CP-SAT, minimizing total tardiness. The baseline schedule achieves 55h makespan with 4 of 10 jobs late and 35 hours of tardiness, structural delays that can’t be scheduled away without changing either the policy or the capacity.
Experiment 1: Express Priority & Extra Packing
Does prioritising express orders help, and does adding a second Packing station pay off?
| Scenario | Makespan | Total Tardiness | Late Jobs | Max Tardiness |
|---|---|---|---|---|

| Baseline (free schedule) | 55h | 35h | 4/10 | 24h |
| Express First (E1 at t=0) | 57h | 37h | 3/10 | 26h |
| Extra Packing (capacity=2) | 54h | 32h | 5/10 | 23h |
| Express First + Extra Packing | 57h | 37h | 3/10 | 26h |
Forcing express priority reduces the count of late jobs but increases total tardiness, and the benefit of extra Packing capacity disappears when express is forced to the front. Prioritising Express cuts late jobs from 4 to 3, but total tardiness climbs by 2 hours, the cost of bumping standard orders. Adding a second Packing station shaves 3 hours off total tardiness in the unconstrained schedule. However, when both interventions are combined, the extra station’s benefit evaporates: the constraint shifts upstream, and Picking becomes the limiting factor.
The business case for a second Packing station is thin on its own: at $200/hour of tardiness cost, payback stretches to 50 weeks. It only makes sense as insurance, not as a throughput play.

Experiment 2: Machine Maintenance Windows
Which machine outage hurts the most?
We block one machine at a time for a 15-hour maintenance window and measure the scheduling impact vs. baseline.

| Machine Down | Window | Makespan Δ | Tardiness Δ | Late Jobs |
|---|---|---|---|---|
| Picking | t=10..25 | +14h (+25%) | +55h (+157%) | 6/10 |
| Packing | t=10..25 | +10h (+18%) | +69h (+197%) | 7/10 |
| Palletize | t=15..30 | +3h (+5%) | +14h (+40%) | 5/10 |
| Express Pick | t=0..10 | 0h | +17h (+49%) | 5/10 |
Packing downtime has a disproportionately large effect on tardiness, worse than Picking downtime, despite Picking carrying more total load. A likely reason: Packing sits at the end of nearly every order’s route, so when it’s blocked, finished work accumulates with no downstream station to absorb it. The Picking outage is what you’d expect from the busiest machine: +14h makespan, +55h tardiness. The Packing outage tells a different story: only +10h makespan but +69h tardiness, nearly double the tardiness penalty. Packing is the final common step for most orders; when it stalls, there is nowhere downstream to recover.
Express Pick downtime is a sleeper risk: zero makespan impact but +17h tardiness. It only affects two jobs, but those are the Express orders with the tightest deadlines. Palletize downtime is manageable (+3h makespan, +14h tardiness), making it a sensible candidate for scheduled maintenance during operating hours.

Experiment 3: Throughput Saturation
How many extra Standard orders can the system absorb before it breaks?
We clone the Standard B2C order type incrementally (each clone adds 16h of work through the core Pick→Pack path) and test feasibility.

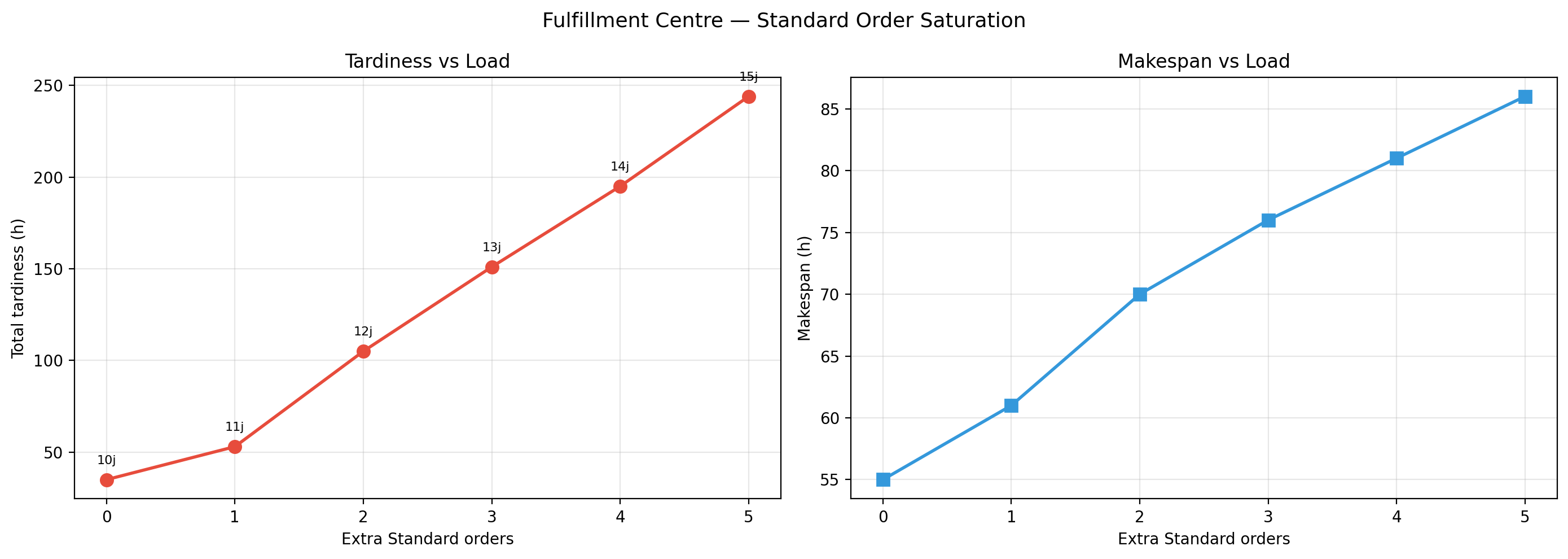

| Extra Clones | Total Jobs | Makespan | Tardiness | Incremental Tardiness |
|---|---|---|---|---|
| 0 | 10 | 55h | 35h | - |
| 1 | 11 | 61h | 53h | +18h |
| 2 | 12 | 70h | 105h | +52h ← 3× jump |
| 3 | 13 | 76h | 151h | +46h |
| 4 | 14 | 81h | 195h | +44h |
| 5 | 15 | 86h | 244h | +49h |
| 6 | 16 | - | UNSATISFIABLE | - |
The system doesn’t degrade gradually, tardiness jumps 3× between the first and second extra order, and the solver finds no feasible schedule beyond 15 total jobs (50% above baseline). Makespan grows linearly (+5–6h per clone), which is predictable. Tardiness does not. The first extra order costs 18h of additional tardiness. The second costs 52h. From there, each additional order piles on ~45–50h of new tardiness. At 15 jobs, cumulative tardiness hits 244h, a 7× increase over baseline. The sixth clone makes the problem unsatisfiable, the combined workload exceeds what the facility can schedule in any configuration.
The practical takeaway: the system absorbs +20% volume with manageable pain, but somewhere between +20% and +30% it crosses a threshold where every additional order cascades delays across the entire job set.

Business Implications
-
End-of-line capacity has outsized impact. Packing downtime produces a larger increase in tardiness than upstream bottlenecks, even when upstream stations carry more load.
-
Hard prioritisation rules can distort performance. Forcing express orders to the front reduces late shipments in that segment but increases overall system delay.
-
System performance degrades non-linearly with volume. The transition from manageable overload to infeasible schedules occurs over a small range of additional demand.
-
Maintenance scheduling should focus on bottleneck sensitivity, not utilisation alone. Some lightly-loaded stations (e.g. Express Pick) still have high impact on deadline performance due to their position in the workflow.
-
Redundancy decisions are driven by tail risk, not average load. The value of a second Packing station is better understood as protection against worst-case disruption than as a throughput upgrade.
Methodology
Experiments used MiniZinc with the CP-SAT solver on a validated job-shop model with real-world operation durations and deadlines. Each scenario was solved to optimality with a 60-second timeout. Raw solver outputs, constraint files, and per-run reports are archived in the experiment subdirectories.
