Movie Production Scheduling: Cutting a Shoot from 179 Days to 65
One actor was the bottleneck. The difference between the best and worst schedule was 114 shooting days and $8.5 million.
Executive Summary
A superhero film with 27 scenes and 4 principal actors appeared straightforward to schedule.
Simulation showed otherwise.
One actor was responsible for nearly every scene and became the production bottleneck. Depending on scheduling choices, the same film could wrap in as little as 65 days or stretch to 179 days. The difference: $8.5 million in production cost.
By testing scheduling scenarios before filming began, production could identify the real constraint, quantify schedule risk, and evaluate mitigation strategies before spending a dollar on set.
The actors and scenarios used in this case study are fictionalized for demonstration purposes.
The Business Question
The production team wanted answers to three questions:
- What is the fastest achievable shooting schedule?
- What happens if actor availability becomes constrained?
- Which interventions reduce schedule duration the most?
To answer them, we modeled every scene, actor dependency, and availability constraint, then evaluated five production scenarios. All costs assume a production day rate of $75,000.
| Scenario | Duration | Cost Impact | |
|---|---|---|---|

| Body Double | 65 days | $2.6M saved | |

| Optimized (Free Schedule) | 100 days | Baseline | |

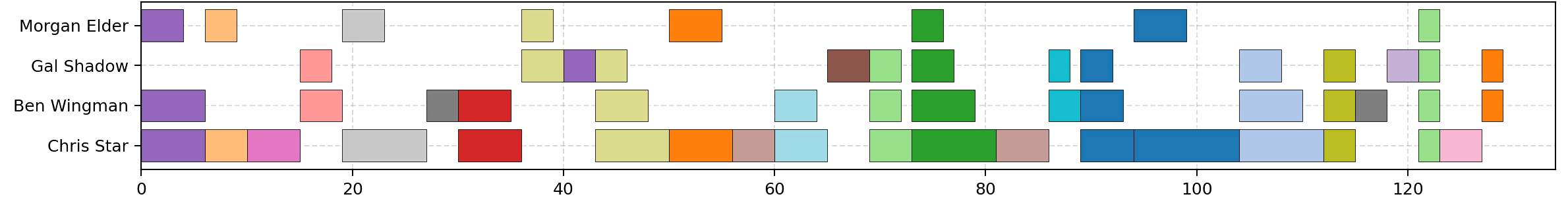

| Script Order | 129 days | +$2.2M | |

| Actor Conflicts | 132 days | +$2.4M | |

| Combined Disruption | 179 days | +$5.9M |
Key Finding
The lead actor appeared in almost every scene and required 100 days of work.
The schedule was therefore constrained not by the number of scenes, locations, or supporting actors, but by a single resource. When that resource became unavailable, production duration increased dramatically. When that resource’s capacity was effectively doubled through a body double or second unit strategy, production duration fell by 35%.
What Drove the Difference
1. Shooting in Script Order Added 29%
Many productions gravitate toward filming scenes in narrative sequence. The model showed this choice increased duration from 100 to 129 days because scenes that could have been filmed independently were forced to wait for earlier scenes to complete.
Impact: +29 days, +$2.2M.

2. Actor Availability Added 32%
A simulated mid production conflict removed the lead actor for 30 days and delayed another actor’s start. Even with optimal rescheduling, production duration increased to 132 days.
Impact: +32 days, +$2.4M.

3. Capacity Expansion Reduced Duration by 35%
The model identified the lead actor as the bottleneck resource. Adding a body double or second unit capability allowed parallel work on scenes that previously competed for the same actor. Production duration fell from 100 to 65 days.
Impact: 35 days saved, $2.6M saved.

4. Multiple Constraints Compound
When actor conflicts were combined with script order shooting, duration expanded to 179 days. The combined impact was far larger than either issue alone because the schedule lost its ability to absorb disruption.
Impact: +79 days, +$5.9M.

Bottom Line
The study did not discover a better schedule. It discovered a better business decision.
Before filming began, production could identify:
- The resource most likely to delay the project.
- The cost of actor availability risk.
- The value of schedule flexibility.
- Whether additional staffing would pay for itself.
The analysis took hours. The difference between the best and worst outcome was 114 shooting days and $8.5 million.
